Fourth-Party Vendor Risk Management: What to Ask Suppliers

What a fourth-party vendor is, how to find yours, what to ask critical suppliers, a triage table and a 90-day plan, with DORA, PRA and NCSC context.
Risk Ledger
|
Company
October 9, 2026
|
23
mins read
Fourth-Party Vendor Risk Management: What to Ask Suppliers

Last updated 8th October. Rewritten to add supplier questions, evidence sources, a triage table and a 90-day plan; corrected the status of PRA SS2/21 and the Cyber Security and Resilience Bill.

Quick answer

Fourth-party vendor risk management is the part of third-party risk management that identifies, assesses and monitors the providers your direct suppliers rely on, focusing on the dependencies behind your critical services rather than every supplier's supplier.

  • A fourth-party vendor is a provider your direct supplier uses to deliver its service to you, such as the cloud platform behind your payroll software.
  • Direct-supplier assessments record each supplier's own controls, so they rarely show when several suppliers share the same underlying provider.
  • Scope follows criticality. Trace the providers behind the services you can't afford to lose, the data you must protect and the access that could cause serious harm.
  • Each material dependency should end in a decision: remediate, prepare a contingency, accept the risk with a named owner, or investigate further.

A UK public sector team running a national testing programme did what good resilience planning recommends. It bought a critical reagent from two separate suppliers, so that if one had an incident or went out of business, it could switch to the other.

When we mapped the supply chain behind those suppliers, both relied on the same fourth party. Each contract looked like a backup for the other, but a problem at that shared provider could have taken out both. The team had pushed its bottleneck one layer further down the supply chain. Once the shared dependency was visible, one supplier moved to a different underlying provider, so the two routes no longer converged. Spotting the dependency was the easy part. Fixing it relied on a supplier agreeing to change its own provider, which isn't always on the table.

This is the problem fourth-party vendor risk management addresses. Your supplier register records who you buy from. It rarely records who those suppliers depend on, and that's where two apparently independent suppliers can turn out to share one point of failure.

You don't need to assess every supplier's supplier. Start with the services you can't afford to lose, trace the providers behind them, and stop when the next layer no longer changes a decision.

This guide covers how to identify fourth-party vendors, the questions to ask critical suppliers, how to prioritise what you find, what to do when a supplier won't disclose its providers, and a 90-day plan with a dependency register you can copy.

‍

What is a fourth-party vendor?

A fourth-party vendor is a supplier or service provider that one of your direct suppliers relies on to deliver its service to you. You usually have no contract with it, yet its outage, breach or change of ownership can still stop your services, expose your data or open a route into your systems.

Fourth-Party Risk Map

Fourth-party status describes a dependency path, not a type of company. The same provider can sit in different positions for different services. Many organisations contract with Microsoft directly for email and identity, and also buy SaaS tools that run on Azure. For the first service, Microsoft is a third party you assess and manage through your own contract. For the second, it's a fourth party, and your view of how that service is hosted, configured and recovered comes through the SaaS supplier. That's why a single entry on your supplier register can understate your exposure to a provider. A hyperscaler, a payment processor or a niche software component can appear once in procurement records and still sit underneath a dozen critical services. Classifying each relationship by the service it supports, rather than by the company's name, is what makes hidden supplier dependencies visible and comparable.

The usual absence of a contract changes how you manage the risk. You can't send a fourth party your questionnaire or enforce your security clauses on it. Assurance normally reaches you through the direct supplier's own oversight, flow-down terms in its contracts, public evidence such as certifications and subprocessor lists, or relationship data suppliers have declared on a shared network. Each route gives you evidence, but less leverage than a direct relationship.

Fourth-party vendor risk management is the process of finding the providers behind your critical suppliers, judging which could materially affect your services, and deciding what to do about each one. It extends your existing third-party programme rather than replacing it. The assessments you already run tell you which direct suppliers matter enough to look behind.

The same position goes by other names. Contracts usually say subcontractor, and data protection teams say sub-processor. DORA refers to ICT subcontractors, and supply chain standards often use sub-tier or lower-tier supplier. Anything further down the chain is usually called an nth party.

There is one caveat. You can only classify dependencies you know about, and most of that knowledge comes from supplier disclosure. A fourth party nobody has declared won't appear on any register, so an empty list records what's been disclosed rather than proving no dependency exists.

‍

Third-party vs fourth-party vs nth-party risk

Third-party risk comes from suppliers you contract with directly. Fourth-party risk comes from the providers those suppliers rely on, and nth-party risk from anything further down the chain. The underlying risks are the same. What changes at each step is how much you can see, how current your evidence is, and how much leverage you have.

The numbering starts with you. Your organisation is the first party, your customer is the second, and the suppliers you contract with are third parties. Procurement teams often use tiers instead. Tier 1 is a direct supplier, tier 2 is a fourth party, and tier 3 onward is an nth party.

Third vs fourth vs nth party

How visibility and leverage change at each layer

The risks are similar at every layer. What changes is how you find out about the relationship, how you gather evidence and how much influence you have.

Comparison of third-party, fourth-party and nth-party risk
DimensionThird partyFourth partyNth party
RelationshipSupplier you contract with directlyProvider a direct supplier uses to deliver its service to youProvider further down the chain
ContractDirect agreementUsually none for this service, though you may contract with the same company for anotherNone
How you know it existsYour supplier registerSupplier disclosure, subprocessor lists or network relationship dataRarely known unless declared through the chain or mapped on a network
Due diligenceYour own assessment and evidence reviewMainly through the direct supplier's oversight, plus public evidenceIndirect, usually limited to concentration and incident checks
LeverageYour contract termsFlow-down clauses and your contract with the direct supplierLittle or none directly
Evidence ageAs current as your last assessmentAs current as the supplier's last review and disclosureOften unknown
Incident informationFrom the supplier, under your notification termsRelayed by the direct supplier, often laterPublic reporting or network signals
ExamplePayroll providerPayment processor the payroll provider usesCloud platform hosting that payment processor
Practical decision rule

Use the label to decide how you'll gather evidence. Use criticality to decide whether to gather it at all.

The practical difference is the route information takes to reach you. With a third party, you set the questions, read the evidence and enforce the contract yourself. With a fourth party, almost everything arrives second-hand. The direct supplier decides what to disclose, summarises its own oversight and passes on incident updates when it has them. Each extra layer adds delay and filtering. During an incident, that can mean hearing from your supplier within hours, or discovering days later that a provider two steps down was involved. It also changes what good evidence looks like. For a third party, a current assessment and a tested recovery plan may be enough. For a fourth party, the more useful evidence is often about the relationship itself: which of your services it supports, whether your supplier assesses it, and whether any of your other critical suppliers depend on it too.

Depth isn't a measure of risk, though. A seventh-party provider sitting underneath several critical services can matter more than a low-impact direct supplier. The label tells you how you'll get evidence. Criticality, covered in how far down the supply chain to look, tells you whether a relationship deserves the effort.

Free tool, 1 minute

How exposed is your supply chain, really?

You just read that most organisations can't see past their direct suppliers. The Supply Chain Risk Exposure Assessment gives you a directional score for your own visibility, concentration risk and threat response speed, benchmarked against the wider network.

‍

Examples of fourth-party vendors

Common fourth-party vendors include cloud hosting platforms, payment processors, identity and verification services, communications APIs, the remote-management tools managed service providers use, and the AI models built into SaaS products. Almost any company can be a fourth party, because the label comes from its position behind your supplier, not its size or sector.

Worked examples

Where fourth-party vendors sit behind common suppliers

Fourth parties rarely appear on your contracts, but these pairings come up again and again behind critical suppliers.

Examples of fourth-party vendors and their potential impact
Direct supplierPossible fourth partyWhat could happen if it fails or is compromised
SaaS providerCloud hosting platformService outage if the platform or region fails, data exposure if it's misconfigured
Payroll providerPayment processorDelayed salary payments, exposure of employee bank details
Managed service providerRemote monitoring and management toolPrivileged access into many customer environments at once
Customer support platformMessaging or communications APIFailed customer notifications, exposure of message content
Data processorSub-processorPersonal data handled outside agreed locations or controls
Identity providerSMS or email verification serviceUsers unable to log in or recover accounts
Logistics providerRoute-planning or tracking platformDelayed deliveries and operational disruption
SaaS product with AI featuresFoundation model providerConfidential data sent to a model you didn't approve, or AI features failing across several tools at once

Direct suppliers vary by sector, but fourth parties tend not to. A manufacturer's industrial control system vendor and a council's case-management supplier have little in common. Both may still run on the same cloud platform, take payments through the same processor and email customers through the same communications API. That's why a short list of providers keeps appearing underneath unrelated supplier relationships.

In our data on critical fourth parties found that the most common were Google, AWS, Microsoft, Salesforce and HubSpot. Familiar names are easy to dismiss as low risk because they're well run. For fourth-party risk, the more useful question about a well-run provider is how many of your critical services it sits under, and whether your backups sit under it too.

How AI tools create fourth parties you didn't choose

Many SaaS products now rely on the same small group of foundation model providers. If several of your tools call the same model, an outage or a change in that provider's data handling reaches all of them at once.

Suppliers also add AI after you've signed. A tool you assessed two years ago may now send your data to a model provider that wasn't in scope when you reviewed it. Sometimes the supplier itself doesn't know.

Engineers within a supplier have introduced APIs into fourth-party AI providers within the technology stack. Confidential data I'm sending to that supplier is then being pulled into an LLM at the fourth-party layer, without that organisation even knowing, because an engineer decided to plug one in.
Haydn Brooks Haydn BrooksCEO and co-founder, Risk Ledger

Subprocessor lists help, but they record approved relationships. They won't show an integration an engineer added without approval, so ask specifically about AI use in your critical supplier questions.

‍

What risks do fourth-party vendors introduce?

Fourth-party vendors introduce five main risks. An underlying provider can fail and disrupt your services. Sub-processors can expose your data. Privileged access can reach across many customer environments at once. Incident response slows down because information travels through your supplier. And one provider can sit underneath several of your critical suppliers at the same time.

These risks come from two different places. Some come from the fourth party failing or being compromised. Others come from you not knowing it's there, which turns a manageable incident into a slow one.

Service disruption

On 18 November 2025, a permissions change in one of Cloudflare's database systems caused a configuration file used by its Bot Management system to double in size. The software routing traffic across Cloudflare's network had a size limit below the new file, so it failed, and sites relying on Cloudflare returned errors for several hours. Plenty of organisations affected that day had no contract with Cloudflare. They lost services because their SaaS suppliers ran behind it. CrowdStrike's July 2024 update shows the same pattern from a different angle. A faulty update crashed around 8.5 million Windows devices. For many organisations CrowdStrike was a direct supplier, but others felt it through suppliers whose own endpoints went down. In both cases, the provider was well run and widely trusted. What determined the impact was how many of your services sat behind it and whether any backup route avoided it.

Data exposure through sub-processors

Your data can sit with a fourth party without any incident happening at all. A supplier may store, back up or analyse it through a sub-processor you've never assessed. Under UK GDPR, you usually remain accountable for that data as the controller, so a breach at the sub-processor is still your problem to explain.

Privileged access

Some fourth parties hold access rather than data. A managed service provider's remote monitoring and management tool can reach into every customer environment that provider supports. MOVEit Transfer is the best-known recent case. The file transfer tool sat behind payroll provider Zellis, and its exploitation exposed employee data at Zellis's clients. Our guide to [hidden supplier dependencies](URL needed: Dependencies pillar) walks through the full chain.

Slower incident response

When Log4J was disclosed, Check Point recorded attempted exploits against more than 48% of corporate networks within three days. Many security teams spent that time emailing suppliers, who were emailing their own suppliers. Each layer in that chain adds delay. By the time an answer comes back, it may describe exposure that attackers have already found.

Shared exposure across suppliers

SitusAMC, which provides technology to more than a thousand financial institutions, disclosed a breach in November 2025 affecting client data. For the banks involved, it was a direct supplier. For any organisation whose own lender or loan servicer relied on it, the same breach arrived as a fourth-party event. Each client sees only its own relationship with a shared supplier, while an attacker can see all of them. That's what makes a shared provider attractive to target. Concentration risk covers how to measure that kind of aggregate exposure.

Diagram of one supplier connected to six client organisations, showing that each client sees only its own relationship while an attacker sees all six
I've had it a few times where a fourth party has been hit, and the client I was working with as a consultant had multiple third parties lose their service at the same time. That magnifies the impact.
Haydn Brooks Haydn BrooksCEO and co-founder, Risk Ledger

Most fourth-party dependencies never cause an incident. Listing the risks is useful only if it helps you decide which ones would matter for your critical services.

‍

Why direct-supplier assessments miss fourth-party risk

Direct-supplier assessments miss fourth-party risk because they're built to evaluate one supplier at a time. A questionnaire records that supplier's own controls. It rarely shows which providers the supplier depends on, whether those overlap with your other suppliers, or what changed after the assessment was completed.

Questionnaires do one job well. They tell you how a supplier secures its own environment, and that evidence still matters. What they weren't designed to show is the structure around the supplier: who it relies on, and who else relies on the same providers.

Most supplier registers follow contracts rather than services. Procurement records the legal entity, contract value and a general description of what the supplier does. The register usually won't distinguish between an identity provider whose failure stops customers logging in and an expenses tool whose failure is an inconvenience. Without that service link, there's no obvious starting point for looking behind a supplier.

The information that would help is usually split across teams. Privacy holds subprocessor lists. Resilience holds business impact assessments. Security holds questionnaire responses, and procurement holds the contracts. Each team sees part of the dependency picture, and nobody owns joining the parts together.

The deeper problem is that each customer collects evidence from a supplier separately. If six organisations assess the same supplier, each gets its own questionnaire back, in its own format, describing the same environment. None of them can see that the supplier's hosting provider also sits behind three of their other critical suppliers, because that pattern only appears when you look across relationships rather than within one.

Supply chain teams tend to assess suppliers individually and haven't treated the supply chain as a system of relationships. Adding fourth-party questions to your questionnaire helps, but the answers are still self-reported, describe a single point in time, and stay inside your own programme. The overlap stays invisible until relationship data from many suppliers sits in one place.

Timing makes it worse. Most assessments run annually, while suppliers add sub-processors and change technology providers throughout the year. Contracts often require notification, but in practice that can mean an updated webpage nobody is watching.

Security leaders recognise this. In our 2026 US research, 96% of CISOs said extended supply chain visibility is essential for managing supply chain risk. [Evidence needed: 2026 UK edition figure on visibility or confidence in TPRM effectiveness, to replace the 73.2% and 37.2% stats]

Every Link Matters Survey Results

‍

How far down the supply chain should you look?

Look as far down the supply chain as a dependency stays material to a critical service. Start with your most critical direct suppliers and trace the providers behind them. Keep going only while the next layer could change a decision about recovery, contracts or risk acceptance.

That breaks into two separate questions. The first is which direct suppliers are worth looking behind. The second is how many layers to follow once you do.

The first question is about criticality, and it should be answered about your business, not the supplier. Teams that do this well rarely try to map their whole supply chain at once. As Haydn describes it, they identify their most critical third parties first and run fourth-party analysis on those, even when they can't cover everything.

Supplier criticality checklist

Does this supplier's own supply chain need a closer look?

Answer each question about your business, not the supplier. Suppliers rarely know how critical they are to you.

Impact

What happens if this supplier fails or is breached?

  • Supports an essential service. Would a service stop without them, with no tested alternative ready in time?
  • Holds sensitive or regulated data. What would exposure of that data cost you, even if nothing stops running?
  • Has access into your systems. What could someone reach or change through that access if the supplier were compromised?
Reach

Is a provider shared underneath this supplier?

  • Relies on a provider several critical suppliers share. If that provider failed, how many of your critical suppliers would be affected at once?
Overrides

Has a regulator already decided for you?

  • Falls under a formal designation. For example, a critical ICT third-party provider under DORA or, once in force, a designated critical supplier under the UK's Cyber Security and Resilience Bill.
Practical decision rule

A yes under Impact, or a formal designation, means trace this supplier's own providers and treat the material ones as fourth parties. A shared provider raises the priority of that work but doesn't decide whether it's needed.

For more depth on the first question, see what makes a supplier critical, how to identify critical suppliers, or score suppliers with the Supplier Criticality Matrix.

The second question needs a stopping rule, because supply chains don't end. Stopping at the fourth party is as arbitrary as trying to map everything. A better test is whether the next layer changes what you would do. Take a SaaS platform that relies on an identity provider. If customers can't log in when that provider fails, the identity provider matters. Behind it may sit an SMS verification service. That service matters too if account recovery is part of your critical service, and it barely matters if it isn't. The same supplier relationship can justify going two layers deep for one service and stopping at one for another. When further investigation isn't feasible, record why, so the decision can be revisited rather than forgotten.

The deeper you go, the less you can trust the data. Information about an nth party has passed through every supplier above it, and each one may have summarised, filtered or outdated it. Record how confident you are in each relationship (confirmed, inferred or unknown) alongside the relationship itself.

Fourth parties and beyond in the supply chain data

‍

How to identify fourth-party vendors

You identify fourth-party vendors by combining several sources, because no single source is complete. The main ones are supplier disclosure, subprocessor lists, SOC reports, architecture and recovery evidence, external technical signals, and relationship data declared on a shared supplier network. Each reveals part of the picture and has limits on what it can prove.

The NCSC's guidance on mapping your supply chain is a useful frame. It treats mapping as recording, storing and using information gathered from suppliers. It also asks organisations to decide up front how far down the chain is worth going, and how much effort they're prepared to invest. The decision about which sources to use follows from that.

Evidence sources

Where fourth-party information comes from, and what it can't prove

No single source gives a complete view. The NCSC's guidance on assessing supply chain cyber security recommends building confidence from several sources over time.

Sources of fourth-party information and their limitations
SourceWhat it can revealWhat it can't establish on its own
Supplier disclosureNamed providers and how the supplier oversees themWhether the list is complete, or independently checked
Subprocessor listsProviders that process personal data on the supplier's behalfOperational dependencies that never touch personal data
SOC 2 reportsSubservice organisations and the controls the supplier relies on them forWhether those providers' controls work, or anything after the report period
Architecture and recovery evidenceWhich providers support the specific service you buy, and the planned failoverThat recovery works, unless it has been tested
External technical signalsLikely technology relationships from DNS, hosting and web dataThe provider's contractual role, criticality or your actual exposure
Shared supplier network dataProviders that suppliers have declared, and overlaps across many suppliersCoverage beyond suppliers who participate, or confirmed incident impact
Software bill of materialsSoftware components and libraries inside a productWhich companies a supplier depends on to deliver its service
Practical decision rule

Record the source and date for every fourth-party relationship. A dependency confirmed by two independent sources can support a decision. One inferred from a single signal is a lead to follow up, not a finding.

SOC 2 reports are a common starting point, and they're easy to over-read. A SOC 2 report covers the supplier's own system. Where the supplier relies on others, such as a cloud host, the report usually treats them as subservice organisations under the carve-out method. It names the service they provide and the controls the supplier assumes they operate, but excludes their controls from testing. The inclusive method, which does test them, is less common because it needs the subservice organisation's cooperation. So a SOC 2 report can tell you that a hosting provider exists and what the supplier relies on it to do. It won't tell you whether that provider's controls work, whether it supports the specific service you buy, or what changed after the report's period ended. When the dependency is material, ask for the subservice organisation's own report.

Subprocessor lists exist because data protection law requires them. Under UK GDPR, a processor can't engage a sub-processor without the controller's prior written authorisation, and it remains liable for the sub-processor's compliance, as the ICO's guidance for processors sets out. That makes the lists reliable for personal data. They usually leave out operational dependencies such as DNS, payment rails or monitoring tools that never touch personal data.

A software bill of materials answers a different question. CISA describes an SBOM as a building block of software supply chain risk management. It records the components inside a piece of software, which tells you whether a vulnerable library is present. It doesn't tell you which companies a supplier depends on to deliver its service.

Each source is partial. Record where every relationship came from and when it was last confirmed, so you know which ones to trust.

‍

What to ask critical suppliers about their fourth parties

Ask each critical supplier which providers it needs to deliver the specific service you buy, what those providers do and can access, how the supplier oversees them, and how recovery works if one fails. Useful answers are specific to the service and backed by evidence. A generic policy shows that a process exists, not that a dependency has been assessed.

The NCSC's supply chain security principles are candid about the starting position. You may have to rely on your immediate suppliers for information about their subcontractors, and building the full picture can take time. The principles also suggest asking what protections you've required of each supplier, and what that supplier has in turn required of its own subcontractors.

Supplier question set

Questions to ask critical suppliers about their fourth parties

Scope each question to the service that made the supplier critical. Add these to your existing assessment rather than sending a separate questionnaire.

Fourth-party questions for critical suppliers, with useful evidence and follow-up
Ask the supplierUseful evidenceFollow up if the answer is weak
Which providers do you need to deliver the service we buy?A dependency list specific to that serviceSeparate the supplier's whole vendor list from what supports your service
What does each provider do, and what fails without it?An architecture or service-flow summaryAsk about the operational consequence, not just the name
What data or system access does each provider have?Data-flow and access descriptionsBring in your privacy and security leads for sensitive data or privileged access
How do you assess and monitor these providers?A recent review summary, open issues and monitoring processAsk for evidence about the named provider, not the policy
How does recovery work if a provider fails?Tested recovery arrangements and the date of the last testChallenge untested failover or "multi-cloud" claims
Does your backup route share any provider with the primary?A comparison of primary and backup dependenciesTest independence rather than assuming it
Which AI services process our data, including ones added since we signed?Named model providers, data handling terms and approval processAsk how engineer-added integrations are detected and approved

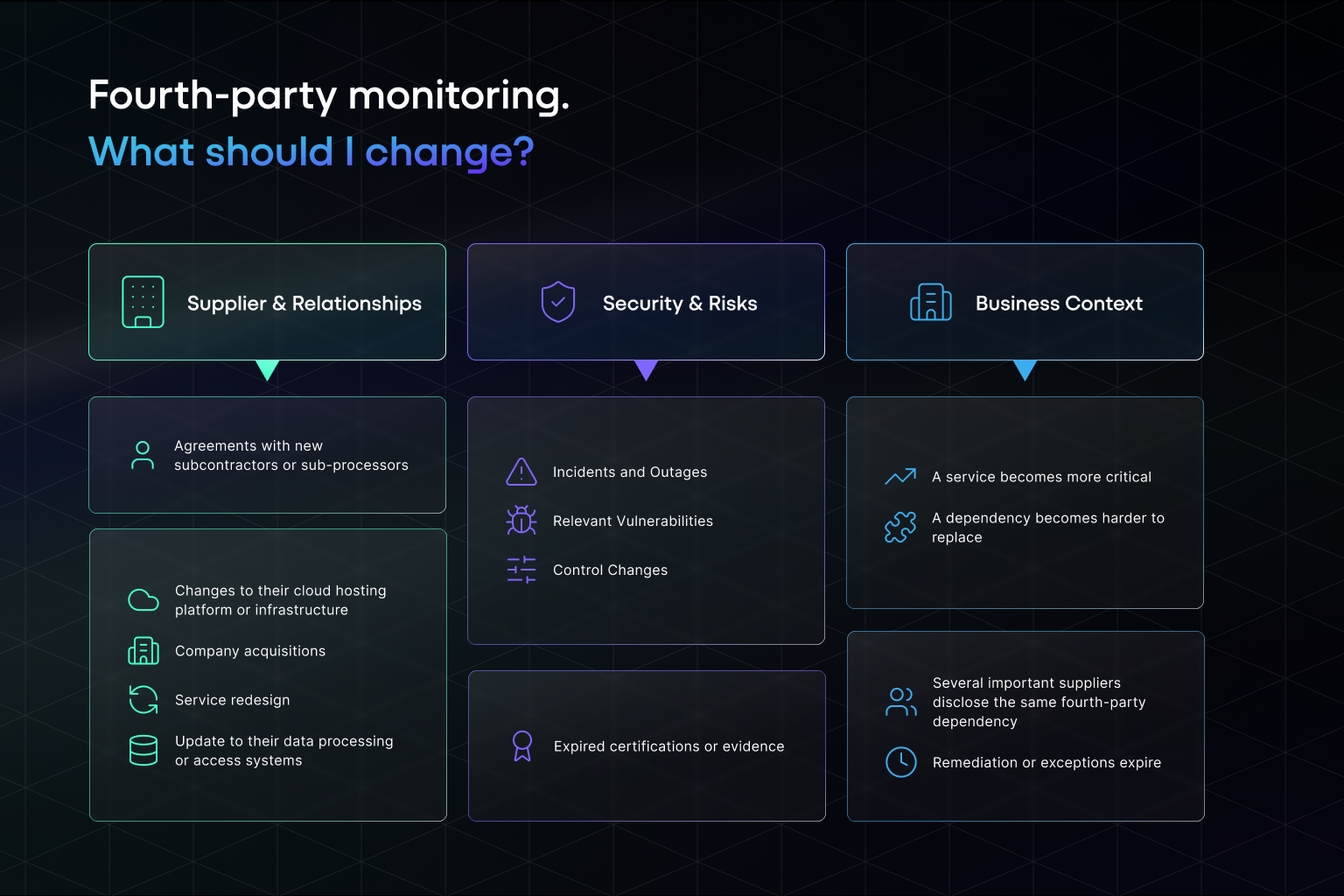

What changes will you notify us about, and how?Contract terms and a named notification routeAgree triggers and contacts, not just a webpage update
Practical decision rule

A policy is evidence that a process exists. Only evidence about the named provider supporting your service counts as evidence that the dependency has been assessed.

Build these questions into the assessments you already run rather than launching a second questionnaire for subcontractors. Scope them to the service that made the supplier critical, so a payroll provider answers about payroll and not its whole estate, and accept existing certifications or reports where they already cover the dependency.

The follow-up matters more than the question. "We assess all our suppliers annually" describes a programme. It doesn't tell you whether the provider hosting your data was in scope last year, what was found, or whether anything is still open. When an answer is generic, ask for the evidence that applies to the named dependency, such as a summary of the most recent review, outstanding issues and the date of the last recovery test. If the supplier supplies only a policy, record it as evidence that a process exists, not as evidence that this dependency was assessed. That distinction keeps your register honest when an auditor or board member asks how you know.

Some suppliers will genuinely not know the answer, particularly about AI tools their engineers have connected. Record "unknown" as a finding with an owner and a review date. It's more useful than a confident answer you can't verify.

‍

How to prioritise fourth-party vendor risk

Prioritise fourth-party risk by consequence, not by the provider's name. A dependency moves up the list when it supports a critical service without tested recovery, holds sensitive data or privileged access with weak evidence behind it, or sits underneath several critical suppliers at once. Each finding should lead to a defined response rather than a score.

Two things decide priority. The first is consequence: what happens to your service, data or access if the provider fails or is compromised. The second is confidence: how much evidence you actually hold about the dependency. A high-consequence dependency with strong, recent evidence can sit lower on the list than a moderate one you know almost nothing about.

Fourth-party triage

What each finding should lead to

Match what you've found to a response. Each one needs an owner and a review date.

Fourth-party findings and recommended responses
FindingRecommended response
Supports a critical service, with no tested recovery inside the time you can tolerateEscalate and agree a resilience action plan with the supplier
Holds sensitive data or privileged access, with weak evidenceRun targeted assurance through the supplier and record the uncertainty
Sits underneath several critical suppliers at onceAssess the combined impact and check whether any backups share it
Can be substituted, with tested arrangements in placeRecord the evidence and monitor for material change
Non-critical, with limited consequence if it failsApply a proportionate review rather than a deep assessment
Material information still unavailable after follow-upEscalate, apply compensating measures or seek time-bound risk acceptance
Practical decision rule

Rank by consequence first, then by how little you know. A dependency you can't evidence is a finding in its own right, not a pass.

Take an illustrative case. A wealth manager runs two customer-facing platforms from different suppliers, and both suppliers disclose the same identity provider. The map tells you there may be a shared failure point. It doesn't tell you that both platforms would fail together, because they might use separate tenants or regions, and one might keep a local login fallback. The next step is to investigate rather than escalate:

  1. Confirm relevance. Check the identity service supports the specific platforms you buy, not just other products from those suppliers.
  2. Check the failure domain. Establish whether both platforms depend on the same tenant, region or control plane.
  3. Look for a workaround. Find out whether either platform can authenticate customers without that provider.
  4. Compare recovery with tolerance. Set the expected recovery time against how long your business can tolerate customers being locked out.
  5. Record the decision. Choose to remediate, prepare a contingency, accept the risk with a named owner, or keep investigating.

Discovery is only the first step, and what you decide afterwards is what counts.

How shared points of failure work

Triage is only as good as the evidence behind it. Missing evidence shouldn't earn a green rating, and it shouldn't automatically trigger escalation either. Treat it as its own category, with an action to close it.

‍

What to do when a supplier won't disclose its fourth parties

When a supplier won't disclose its fourth parties, narrow the request to the dependencies behind your critical service, explain why you need the information, and offer a proportionate way to share it. If that still fails, use alternative evidence, record exactly what you couldn't get, and apply compensating measures or time-bound risk acceptance.

Refusals usually come from one of two places, and each needs a different response. Some suppliers worry that a list of their providers is commercially sensitive, or a useful target map for an attacker. Others simply don't know, because nobody has ever asked them to trace the providers behind a specific service. The first needs reassurance about how the information will be handled. The second needs a narrower question they can actually answer.

A workable sequence looks like this:

  1. Narrow the request. Ask only about providers supporting the service you buy, not the supplier's whole vendor list.
  2. Explain the purpose. Say what decision the information supports, such as recovery planning or incident response.
  3. Offer a proportionate format. A confidential summary, a call, or disclosure of provider categories rather than names may be enough.
  4. Use your existing rights. Check the contract for disclosure, audit or notification terms, and escalate through the account owner.
  5. Look for alternative evidence. SOC reports, subprocessor lists and external signals can fill part of the picture.
  6. Record the specific gap. Note what you asked for, what you received and why it matters.
  7. Decide and set a review point. Apply compensating measures or seek time-bound risk acceptance, then revisit at renewal, after a material change or after an incident.

"We can't make our supplier stop using AWS"

Usually that's true, and it isn't the goal. Getting a supplier to move off a hyperscaler is rarely realistic. The question is whether your own service can survive that provider having a bad day. Haydn describes a few practical routes from incidents he's worked on. If your backup supplier turns out to share the same critical fourth party as your primary, you can switch to a different backup, or ask the backup to change its own provider.

Where neither is possible, some teams keep a third option ready: a supplier they don't yet have a contract with, but whom they've vetted, know they could switch their application to, and have a number ready to call. Other routes include stronger recovery evidence from the supplier, better isolation in your own architecture, contractual commitments on notification and support, or explicit acceptance of the risk with a named owner. Each one reduces the impact of the dependency without removing it.

A refusal isn't proof that a supplier is unsafe, and termination is rarely the proportionate response. Your leverage is usually strongest at renewal, so write disclosure and notification terms into the next contract rather than fighting over the current one.

‍

How to monitor fourth-party vendors and respond to incidents

Monitoring fourth-party vendors means setting triggers that prompt action, not watching every provider all the time. The useful triggers are a new material dependency, a relevant incident or exploited vulnerability, expiring recovery evidence, several suppliers disclosing the same provider, and an expiring risk exception. Each trigger needs a named owner and a defined response.

"Continuous monitoring" is easy to promise and hard to define. In practice, it's an operating process that turns a change into a decision within a known timeframe.

Monitoring triggers

What should prompt a fourth-party review, and who acts

Fourth-party monitoring triggers, owners and actions
TriggerOwnerAction
A supplier adds a material providerSupplier assuranceConfirm whether it supports your service, then reassess
A provider you depend on has an incident or exploited vulnerabilitySecurity operations and the service ownerEstablish actual exposure and prepare contingency
Recovery evidence passes its review dateResilience leadRequest updated evidence or a new test
Several suppliers disclose the same providerTPRM lead with service ownersReview combined exposure and whether backups share it
A supplier changes ownership or major technologySupplier assuranceRe-confirm dependencies and notification terms
A risk exception expiresAccountable risk ownerRemediate, or renew with a documented reason

The most valuable trigger is usually an exploited vulnerability in a technology you depend on indirectly. Most security operations teams already have a workflow for this in their own estate. They track sources such as CISA's Known Exploited Vulnerabilities catalogue, check whether the affected product is in use, and patch it. Extending that workflow into the supply chain is mostly a matter of adding supplier technologies to the list being checked. The constraint is data. The SOC can't add a fourth-party technology it doesn't know about, and that knowledge usually sits with the supply chain team, in questionnaire answers, subprocessor lists and supplier declarations. When the two teams share a dependency record, an advisory about a widely used file transfer tool or identity service becomes a short list of suppliers to contact that morning. Without the shared record, the same advisory becomes a mass email to every supplier asking whether they're affected.

When something does break, the first hour decides how the rest of the incident runs:

  • Identify known dependency paths from the affected provider to your services.
  • Separate confirmed exposure from possible exposure, and say which is which in every update.
  • Name the affected services and their internal owners.
  • Ask suppliers for specific updates covering the service, region and configuration you use, not a generic statement.
  • Check whether any backup shares the affected provider before invoking it.
  • Activate proportionate contingency for the services that need it.
  • Record decisions and open questions, and set the time of the next update.

A dependency map tells you who might be exposed, not who is. It also only covers relationships someone has declared or discovered. Treat it as the starting list for the first hour, and expect to add to it.

‍

What regulators and standards expect on fourth-party risk

No major rule uses the term "fourth party", but several regulators and standards expect you to understand the subcontractors behind your critical services. DORA's subcontracting standard is the most prescriptive. The PRA, the NCSC's Cyber Assessment Framework and NIST SP 800-161 set similar expectations, and the UK's Cyber Security and Resilience Bill would extend them further.

Read side by side, they converge on three ideas. Oversight should be proportionate to how critical the service is. Visibility of subcontractors usually comes through the direct supplier. And your contracts should give you the right to that information and to notice when it changes.

Regulatory expectations

How regulators and standards treat fourth-party risk

Status checked October 2026. Confirm scope and dates for your own entities before relying on them.

Regulations and standards relevant to fourth-party risk, with scope, status, expectations and evidence to keep
SourceWho it applies toStatusWhat it expectsEvidence to keep
DORA subcontracting RTS (EU) 2025/532EU financial entities in DORA scopeIn force since 22 July 2025Due diligence, conditions and change management for subcontracted ICT services supporting critical or important functionsSubcontracting chain, due diligence records, material-change assessments
PRA SS2/21PRA-regulated firms, including banks and insurersNovember 2024 version current. March 2026 version effective 18 March 2027Oversight of material outsourcing, including risks from sub-outsourcingOutsourcing register, sub-outsourcing assessments, exit and recovery plans
NCSC CAF Principle A4Organisations assessed against the CAF, including NIS-regulated operators and much of the public sectorCurrent guidanceUnderstanding and managing security risks arising from the supply chainSupply chain map, security requirements in contracts, assurance records
NIST SP 800-161r1US federal agencies, and widely used voluntarilyRevision 1 May 2022, updated November 2024Cybersecurity supply chain risk management across suppliers and their supply chainsSupply chain risk plan, supplier inventory, notification agreements
UK Cyber Security and Resilience BillWould amend the NIS Regulations 2018, extending scope to more digital services and designated critical suppliersBill before Parliament, not yet lawProposed powers to designate critical suppliers and widen supply chain dutiesA view of which of your suppliers could be designated
Practical decision rule

Whatever applies to you, the common test is the same. For each critical service, can you name the subcontractors behind it, show how you assessed them and show how you'd hear about a change?

DORA is the clearest example of fourth-party risk becoming an obligation. Commission Delegated Regulation (EU) 2025/532 was published in the Official Journal on 2 July 2025 and entered into force on 22 July. It applies when a financial entity uses ICT services that support critical or important functions and those services are subcontracted. It covers the due diligence and risk assessment a financial entity must carry out on that subcontracting, the conditions under which subcontracting is allowed, what happens when subcontracting arrangements change materially, and when the entity can terminate. The adopted text is lighter than the draft.

The European Commission removed an article that would have made certain subcontracting clauses mandatory in contracts, so firms have some discretion over wording. They don't have discretion over knowing the chain. If you can't say which subcontractors support an ICT service behind a critical or important function, you can't show that you assessed them.

*This is a summary, not legal advice. Check which rules apply to your entities, and confirm current status before relying on any date.

‍

A 90-day plan for fourth-party vendor risk management

A 90-day fourth-party pilot should cover one critical service, not your whole supply chain. Spend the first month scoping and collecting evidence, the second validating dependencies and agreeing actions, and the third testing the workflow with an incident exercise. The output is a register, a set of owned decisions and an informed choice about where to expand.

Starting with one service keeps the work inside the capacity of a lean team. It also gives you something concrete to show leadership within a quarter, rather than a mapping programme with no visible end.

90-day pilot

A fourth-party pilot for one critical service

An illustrative plan, not a regulatory requirement. Supplier response times will shape the real schedule.

90-day fourth-party risk management pilot plan
PeriodFocusOutput
Days 1 to 30Choose one critical service, agree ownership, list its direct suppliers and send scoped fourth-party questionsA scoped dependency register and a list of information gaps
Days 31 to 60Validate material dependencies, check whether backups share providers and agree responses to each findingPrioritised findings with an owner and review date for each
Days 61 to 90Run an incident exercise, set monitoring triggers and review what the pilot taught youA tested workflow, a reporting baseline and a decision on where to expand

The register is the core output. For each material dependency, record:

  • The business service and its internal owner
  • The direct supplier and the product or service it provides
  • The fourth-party provider and what it does for that service
  • Region or location, where known
  • Data handled and system access held
  • What happens if it fails, and any alternative or workaround
  • Recovery evidence and the date it was last tested
  • Other critical services that share the same provider
  • Where the information came from, and when it was last confirmed
  • Confidence level: confirmed, inferred or unknown
  • Required action, owner and review date

Keep one distinction in view while filling it in. A supplier telling you it uses a provider doesn't establish that the specific service you buy depends on it. Record supplier-wide information as inferred until it's confirmed for your service.

A successful pilot means you can explain the service's material dependencies, show what you still don't know, name who owns each risk, and demonstrate what happens when something changes. It doesn't mean discovering the largest possible number of fourth parties. A short register where every line has an owner and a date is more useful to a board than a long one nobody acts on.

The measures worth tracking are practical ones: how much of the scoped service's supply chain you can describe, how old your evidence is, how many material gaps remain open, how many actions are overdue, and how long it took to establish exposure during the exercise. That last measure is often the most persuasive, because it turns an abstract visibility problem into a number of hours. Run the exercise against a realistic scenario, such as a widely used provider going offline. The NCSC's Exercise in a Box includes a supply chain scenario you can adapt.

For board reporting, one block per material dependency is usually enough:

  • Service: [name]
  • Material dependency: [provider and function]
  • Exposure: [services, data or access potentially affected]
  • Evidence confidence: [confirmed, inferred or unknown, with date]
  • Recovery position: [tested arrangements and limitations]
  • Decision: [remediate, contingency, accept or investigate]
  • Owner and deadline: [name and date]
  • Open questions: [specific gaps]

The timetable is illustrative. Supplier response times usually set the pace, and much of the first month can be spent waiting for answers.

‍

What to look for in fourth-party risk management software

Fourth-party risk management software helps once spreadsheets can no longer keep relationships current. When you evaluate it, look at how it finds fourth parties, whether it separates confirmed from inferred relationships, how it shows shared dependencies, how quickly it reflects change, and how much work it creates for your suppliers and your own team.

Every tool answers two questions differently. The first is where the relationship data comes from. The second is what the tool lets you do with it once it's there. Most of the practical trade-offs follow from the first.

Approaches compared

Three ways to find and track fourth parties

Comparison of manual, outside-in and supplier-network approaches to fourth-party risk
ApproachHow it finds fourth partiesStrengthsLimitsBest fit
ManualQuestionnaires, contracts and spreadsheetsLow cost, fully under your control, service-specific questionsSlow to update, hard to spot overlaps, depends on one person's upkeepSmall pilots and a handful of critical suppliers
Outside-in signalsScanning DNS, hosting and web technology dataFast, needs no supplier effort, broad coverageInfers relationships, can't confirm criticality or which service uses a providerEarly discovery and leads to follow up
Supplier-declared networkSuppliers declare their own critical providers once, visible to their customersDeclared relationships, overlaps visible across suppliers, reused across customersCoverage depends on supplier participation and accurate declarationsOngoing oversight of critical suppliers and shared dependencies
Practical decision rule

Choose by where you need confidence. Inferred signals are good at finding leads. Declared relationships are better for decisions. Many teams use both.

The most reliable test is a demonstration on your own data rather than a vendor's sample. Pick one of your critical suppliers and ask to see its fourth parties, where each relationship came from, when it was last confirmed, and which of your other suppliers share the same providers. Then ask what the tool shows for a critical supplier that isn't already on the platform or hasn't responded. That second answer tells you more about real-world coverage than any headline figure. Feasibility matters as much as features. Ask how many of your suppliers would need to take part, what they'd be asked to do, how long a typical rollout takes for a team your size, and what the cost looks like once you add the suppliers you actually need covered. A tool that maps your supply chain beautifully but needs a dedicated analyst to keep it current may not suit a team of two.

Before shortlisting, ask each vendor:

  • How do you distinguish confirmed relationships from inferred ones?
  • How does a change at a supplier, such as a new provider, reach us, and how fast?
  • Can we see which of our critical suppliers share a provider, and whether any backup routes overlap?
  • What do suppliers have to do, and how many of ours already take part?
  • What happens to our coverage when a supplier doesn't respond?

No tool gives a complete view of an extended supply chain. Coverage depends on supplier participation, signal quality or both, so ask each vendor to show you where its view ends. For broader platform criteria, our TPRM software buyer's guide covers the full evaluation.

‍

How we support fourth-party risk management at Risk Ledger

We built Risk Ledger so suppliers declare their critical suppliers once, in their own profile, and every customer connected to them can see those fourth-party relationships. Fourth-party discovery stops being a question each customer asks separately and becomes shared data you can trace across your whole supply chain.

How it works for suppliers

  • Within their assessment, suppliers list the critical suppliers they rely on.
  • If a provider is already on the Risk Ledger network, they link to its profile.
  • If it isn't, they create a new unclaimed profile with its name, location and website.
  • Suppliers keep the list current as part of their assessment, so it's maintained by the people who manage those relationships.

What you can see and do as a customer

  • See declared fourth parties on each supplier's profile.
  • Trace impact paths from a provider back to your suppliers in our network visualisation.
  • Spot shared providers where several of your critical suppliers rely on the same fourth party. That's how we found the shared reagent supplier in the case at the top of this guide.
  • Export fourth-party data to CSV to populate your dependency register rather than building it by hand.
  • Start incident response from a list. When a widely used provider is disrupted, you begin with the suppliers that declared it, not a mass email.

What suppliers get from it

  • They declare their dependencies once instead of answering a separate fourth-party questionnaire from every customer.
  • If one of their own providers is disrupted, they can notify all their connected customers through the platform.
Systemic concentrations are a real concern because it's often not directly with your first-tier supplier, it's second or third. So being able to track that to understand where that risk is coming from is very powerful.
Wendy Brett Reynolds CISO, Succession Wealth
Risk Ledger Fourth Party Vendor Risk Management

‍

What security teams ask next about fourth-party risk

‍

Fourth-party vendor risk management FAQs

FAQs

Fourth-party vendor risk management FAQs

What is a fourth-party vendor?

A fourth-party vendor is a supplier or service provider that one of your direct suppliers relies on to deliver its service to you. You usually have no contract with it, but its outage or breach can still disrupt your services, expose your data or open a route into your systems. The same company can be a third party for one service and a fourth party for another.

What is fourth-party vendor risk management?

Fourth-party vendor risk management is the part of third-party risk management that identifies, assesses and monitors the providers your direct suppliers rely on. It focuses on the dependencies behind your critical services and ends in a decision for each material one: remediate, prepare a contingency, accept the risk with a named owner, or investigate further.

What is the difference between third-party and fourth-party risk?

Third-party risk comes from suppliers you contract with directly, so you can assess them and enforce your contract. Fourth-party risk comes from the providers those suppliers use. The risks are similar, but your visibility, evidence and leverage mostly reach you through the direct supplier, often later and in less detail.

Do we need to assess every fourth party?

No. Start with the suppliers behind your most critical services, trace the providers they rely on, and keep going only while the next layer could change a decision about recovery, contracts or risk acceptance. Record where you stopped and why, so the decision can be revisited.

How do you identify fourth-party vendors?

Combine several sources, because none is complete on its own. Useful ones include supplier disclosure, subprocessor lists, SOC reports, architecture and recovery evidence, external technical signals and relationship data declared on a shared supplier network. Record the source and date for each relationship, and treat anything based on a single inferred signal as a lead to confirm.

What should we do if a supplier won't disclose its fourth parties?

Narrow the request to the dependencies behind your critical service, explain why you need the information and offer a proportionate format such as a confidential summary. If that fails, use alternative evidence, record the specific gap, and apply compensating measures or time-bound risk acceptance. Renewal is usually the best time to add disclosure terms to the contract.

Does DORA require fourth-party risk management?

DORA doesn't use the term fourth party, but its subcontracting standard, Commission Delegated Regulation (EU) 2025/532, sets requirements for subcontracted ICT services that support critical or important functions. It covers due diligence, conditions for subcontracting, material changes and termination rights. It applies to financial entities in DORA scope and has been in force since 22 July 2025.

Is a supplier's SOC 2 report enough to understand its fourth parties?

Not on its own. A SOC 2 report usually names subservice organisations, such as a cloud host, and the controls the supplier relies on them for. Under the common carve-out method, it doesn't test those providers' controls. It also won't show whether a provider supports the specific service you buy, or what changed after the report period ended.

How often should fourth-party risk be reviewed?

Review on triggers, not only on a calendar. A new material provider, an incident or exploited vulnerability at a provider you depend on, expiring recovery evidence, several suppliers disclosing the same provider, or an expiring risk exception should each prompt a review with a named owner. Annual reassessment on its own misses the changes in between.

‍

Sources

Cloudflare outage on November 18, 2025, Cloudflare
CrowdStrike IT outage affected 8.5 million Windows devices
, BBC News
MOVEit vulnerability
, National Cyber Security Centre
The numbers behind Log4j vulnerability CVE-2021-44228
, Check Point
Major US banks impacted by SitusAMC hack
, SecurityWeek
Mapping your supply chain
, National Cyber Security Centre
How to assess and gain confidence in your supply chain cyber security
, National Cyber Security Centre
What does it mean if you are a processor?
, Information Commissioner's Office
Software Bill of Materials (SBOM)
, Cybersecurity and Infrastructure Security Agency
Supply chain security principles: understand the risks
, National Cyber Security Centre
Known Exploited Vulnerabilities Catalog
, Cybersecurity and Infrastructure Security Agency
Commission Delegated Regulation (EU) 2025/532 on subcontracting ICT services supporting critical or important functions
, EUR-Lex
SS2/21 Outsourcing and third party risk management
, Bank of England Prudential Regulation Authority
Cyber Assessment Framework Principle A4: Supply chain
, National Cyber Security Centre
SP 800-161 Rev. 1 Update 1: Cybersecurity Supply Chain Risk Management Practices for Systems and Organizations
, National Institute of Standards and Technology
Cyber Security and Resilience Bill
, GOV.UK
Exercise in a Box
, National Cyber Security Centre

Blog

Download for free

Pattern Trapezoid Mesh

Get the security manager's briefing

Monthly research, case studies and practical guides you won't find anywhere else.

Join thousands of security managers turning their TPRM programmes into success stories.
